Subfloor Preparation Guide: How to Prepare Floors for Wood, Laminate & LVT
Why Subfloor Preparation Matters
Subfloor preparation isn’t optional. It’s the single biggest factor affecting how your new floor performs over time.
In most cases, flooring doesn’t fail because of the product itself — it fails because the surface beneath it wasn’t properly prepared. Issues such as:
- Excess moisture
- Uneven or out-of-tolerance substrates
- Structural movement
- Surface contamination
- Incorrect priming or levelling
can all compromise the finished result, regardless of how high-quality the flooring is.
Whether you’re installing engineered wood, solid hardwood, laminate, click LVT (SPC), or glue-down LVT, the principles of correct subfloor preparation remain the same.
This guide sets out clear, practical, UK-relevant standards to help you prepare your subfloor correctly before installation. It’s designed for confident DIYers, professional fitters, and anyone who wants to ensure their new floor performs exactly as it should — from day one.
Installation Guide Contents
- 1. Identify Your Subfloor Type
- 2. Subfloor Performance Requirements
- 2.1 Moisture Control
- 2.2 Flatness & Level Tolerances
- 2.3 Structural Stability
- 3. Surface Preparation & Bond Readiness
- 3.1 Cleaning & Mechanical Surface Preparation
- 3.2 Surface Treatments - Primers, DPMs & Levelling Compounds
- 4. Environmental Conditions & Acclimatisation
- 5. When to Seek Professional Assessment
- 6. Technical Quick Reference Table
- 7. Frequently Asked Questions on Subfloor Preparation
1. Identify Your Subfloor Type
Before carrying out any preparation work, you must first confirm exactly what type of subfloor you’re dealing with.
Different substrates behave differently. They absorb moisture at different rates, respond differently to temperature changes, and require different preparation products. Treating them the same can lead to installation failure.
Common Subfloor Types in UK Homes
Concrete Slab
Typically found in ground-floor properties, extensions, and many new builds. Usually incorporates a damp proof membrane (DPM), though older properties may not. Moisture testing is essential.
Sand & Cement Screed
Laid over a concrete slab to create a smoother surface. Drying times can be lengthy, and moisture levels must be confirmed before installation.
Anhydrite / Liquid Screed
Often used in modern developments, particularly with underfloor heating. Requires sanding to remove laitance and stricter moisture thresholds before flooring is installed.
Timber Floorboards
Common in period properties and upper floors. These require structural checks for movement, deflection, and moisture consistency.
Plywood or Chipboard Decking
Typically found on upper floors or over joists. Thickness, stability, and fixing condition must be assessed before installation.
Beam & Block Construction
Precast concrete beams with infill blocks, commonly used in modern builds. Usually topped with screed. Moisture and flatness must be verified before flooring is laid.
2. Subfloor Performance Requirements
Before any flooring is installed, the subfloor must meet three core performance criteria:
- Moisture levels within tolerance
- Flatness within acceptable deviation
- Structural stability under load
All three must be satisfied. Meeting one does not compensate for failing another.
2.1. Moisture Control
Moisture is the leading cause of flooring failure in the UK. It can cause cupping, lifting, adhesive breakdown, joint separation, and long-term structural damage.
Moisture must always be tested — never assumed.
Concrete & Screed Subfloors
All concrete and screed substrates must be tested using an approved method before flooring installation.
Recommended Test Method
- In-situ hygrometer (relative humidity probe test)
- Test multiple areas, including near external walls and service penetrations
- Seal the probe and allow sufficient time for the reading to reach equilibrium — typically between 24 and 72 hours, depending on site conditions and test method.
Testing should be carried out in accordance with BS 8203 or the relevant flooring standard. Surface moisture meters are not sufficient on their own for installation approval.
Maximum Acceptable Moisture Readings (General Guidance)
- Standard bonded flooring: Maximum 75% RH
- If no structural DPM is confirmed: Apply an appropriate surface damp proof membrane
- Anhydrite / liquid screed: Typically below 0.5% CM (check manufacturer specification)
Always follow the flooring and adhesive manufacturer’s stated limits where they differ.
Drying Times – A General Guide Only
Drying time depends on thickness, ventilation, temperature, and humidity.
As a rule of thumb:
- Approximately 1mm per day up to 40mm thickness
- Approximately 2mm per day beyond 40mm
Fast-drying or proprietary screeds may vary significantly — manufacturer guidance must be followed.
Time alone is not proof of dryness. A screed that has been down for months may still fail moisture testing.
Timber Subfloors – Moisture Control
Timber subfloors behave differently from concrete. They are hygroscopic, meaning they absorb and release moisture in response to changes in humidity. This movement must be controlled before installation.
Test Method
Moisture testing should always be carried out before installing any wood, laminate, or LVT flooring over timber substrates.
Use:
- A calibrated pin-type moisture meter
- Test multiple boards across the room
- Check areas near external walls, chimney breasts, and radiator pipe penetrations
- Record readings for reference
Surface-level testing is not sufficient — readings must be taken within the board.
Acceptable Moisture Content
For most timber installations:
- 8–12% moisture content is considered acceptable
- The subfloor should be within 2–4% of the moisture content of the flooring being installed
Excessive variation between the subfloor and the new flooring increases the risk of movement, cupping, and joint stress.
If Moisture Readings Are Too High
Do not proceed with installation.
Instead:
- Improve subfloor ventilation (particularly in suspended timber floors)
- Check air bricks are clear and unobstructed
- Identify and resolve plumbing leaks or damp ingress
- Allow additional time for the environment to stabilise
Installation must not proceed until moisture levels are within acceptable limits.
2.2 Flatness & Level Tolerances
A floor can appear flat to the eye and still fall outside acceptable installation tolerances.
Even small deviations can cause:
- Joint stress
- Lipping between boards
- Click system failure
- Hollow spots under bonded flooring
- Premature wear
Flatness must be measured, not judged visually.
UK Industry Tolerance
As a general standard:
Maximum deviation: 3mm over 2 metres
(unless the flooring manufacturer specifies otherwise)
This should be checked using a 2-metre straight edge placed in multiple directions across the floor.
Do not rely on spirit levels or sightlines alone. Flatness must be measured correctly using a straight edge.
On-Site Check Tip: A £2 coin is approximately 2.4–2.5mm thick. If a single coin easily slides beneath a 2-metre straight edge, the floor is approaching the 3mm tolerance limit. If two coins fit, the deviation is clearly beyond acceptable limits and levelling will be required.
Concrete Subfloors
Concrete and screed substrates frequently require correction before flooring installation.
Common corrective methods include:

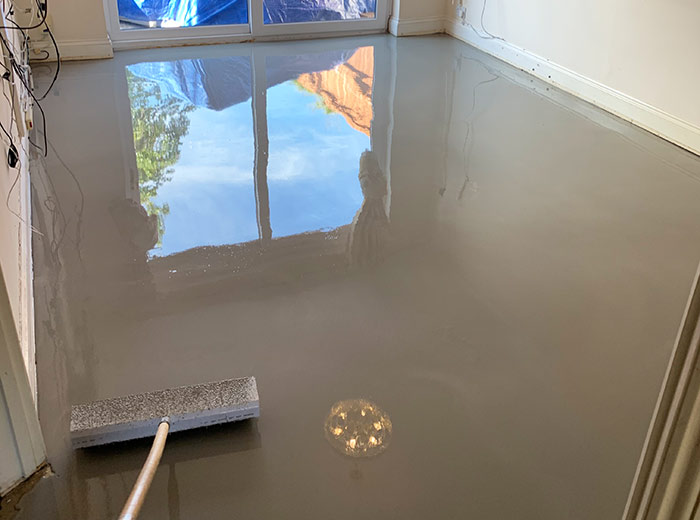

- Application of self-levelling compound
- Application of smoothing compound
- Grinding down high spots
- Repair mortar for localised dips or damaged areas
Minimum levelling depth is typically around 3mm, though this depends on the product used and the condition of the substrate.
For glue-down LVT and bonded wood flooring, surface smoothness is especially critical — imperfections can telegraph through the finished floor.
Timber Subfloors
With timber substrates, flatness and structural movement must both be assessed.
Check for:
- Excessive deflection between joists
- Inadequate joist spacing
- Board movement under load
- Squeaks or loose fixings
Any vertical movement must be addressed before installation.
Common corrective measures include:
- Reinforcing joists where necessary
- Installing noggins between joists to reduce movement
- Overlaying existing floorboards with a minimum 9 mm flooring-grade plywood (such as SP101 or BS EN 636-2 compliant), suitable for humid conditions and free from core voids. Where boards are being installed directly over joists, a structural deck of typically 18 mm thickness or greater is normally required.
- Using 6mm hardboard only for resilient flooring applications
- Screwing down loose boards
Floating floors can tolerate minor surface texture — but they cannot tolerate structural movement.
2.3 Structural Stability
Compliance with moisture and flatness requirements does not guarantee performance. Structural stability must also be confirmed.
If the base moves, cracks, flexes, or degrades under load, that movement will transfer directly into the finished floor.
Stability is critical for both floating and bonded installations.
Concrete Integrity
Concrete and screed bases must be sound and capable of supporting the intended flooring system.
Check for:
- Structural cracks — wide, active, or stepped cracking may indicate movement and should be professionally assessed
- Shrinkage cracks — typically fine and stable, but must still be evaluated
- Laitance — a weak, dusty surface layer common with anhydrite screeds; this must be mechanically removed before priming or bonding. Ideally, laitance should be removed approximately 7–10 days after the screed is laid. Delayed removal can make the surface significantly harder to prepare and may affect bond performance.
- Hollow spots — tap-testing can help identify delaminated or poorly bonded screed areas
- Adequate compressive strength — particularly important for bonded wood and glue-down LVT installations
For bonded flooring systems, the substrate must have sufficient pull-off strength to ensure adhesives perform correctly. Weak or friable surfaces will result in bond failure.
If there is any doubt about substrate integrity, it must be rectified before installation proceeds.
Timber Subfloors
Timber substrates must be both structurally secure and dimensionally stable.
Ensure:
- A minimum thickness of 18mm where required for standard installations
- No signs of rot, fungal decay, or water damage
- No excessive flex between joists
- Boards are securely fixed with no lifting or movement
Walk the floor and apply weight across multiple areas. Any noticeable movement must be addressed.
Common remedies include:
- Re-fixing loose boards
- Adding additional fixings
- Reinforcing joists
- Installing a structural flooring-grade plywood overlay (e.g. SP101 or BS EN 636-2), correctly fixed and free from core gaps.
Movement under load will not “settle” once the flooring is installed — it will transfer directly through to the finished surface.
3. Surface Preparation & Bond Readiness
Once moisture, flatness and structural stability have been confirmed, the substrate must be prepared to ensure proper adhesion.
Preparation at this stage determines whether primers, levelling compounds and adhesives perform as intended. Even a compliant subfloor can fail if the surface is contaminated or improperly treated.
3.1 Cleaning & Mechanical Surface Preparation
Surface contamination is one of the most common causes of adhesive failure.
Adhesives and levelling compounds rely on direct contact with a clean, sound substrate. If contaminants are present, bond strength is compromised — even where the floor appears flat and dry.
For this reason, all substrates must be thoroughly prepared before any priming, levelling, or bonding takes place.
Remove All Contamination
The surface must be free from:
- Old adhesive residue
- Paint or plaster contamination
- Oil or grease
- Dust and fine particles
- General construction debris
Do not assume that sweeping alone is sufficient.
Chemical Cleaning
Where oil or stubborn contamination is present, specialist products may be required:
- Degreasers for oil-contaminated concrete
- Adhesive removers for bonded residue
Chemical cleaning must be followed by thorough rinsing and drying in accordance with product instructions.
Mechanical Preparation Methods
Mechanical preparation is often the most reliable method of ensuring a clean, keyed surface.
Common methods include:
- Shot blasting – effective for removing surface contamination and opening up concrete
- Diamond grinding – used to remove laitance, adhesives, or uneven patches
- Sanding – suitable for timber substrates
Mechanical preparation also helps create a surface profile that improves primer and adhesive performance.
Dust Control
Dust must be fully removed before any primer or adhesive is applied.
Professional dust extraction systems should be used during mechanical preparation. Residual dust can significantly reduce bond strength and lead to long-term failure.
A substrate should feel clean and solid — not dusty or chalky — before proceeding to the next stage.
3.2 Surface Treatments - Primers, DPMs & Levelling Compounds
Once the subfloor is clean, dry, flat, and stable, preparation usually comes down to three key elements:
- A surface damp proof membrane (where required)
- The correct primer
- A suitable levelling compound
Used properly, these products create a stable, bondable surface and help prevent moisture-related issues.
When to Use a Surface DPM (Liquid DPM)
A surface DPM is used to control residual moisture and protect the flooring system where a structural DPM is missing, uncertain, or the substrate has tested high.
You should normally consider a surface DPM where:
- There is no confirmed structural damp proof membrane (common in older properties)
- Moisture readings are above 75% RH
- You are working on ground floors, basements, or areas with higher damp risk
Most liquid DPM systems are applied in two coats, with a specified drying time between coats. Always follow the manufacturer’s coverage rate and cure times — applying too thinly is a common failure point.
Primers
Primers are not a “nice to have”. They are used to stabilise the surface and ensure preparation products bond correctly.
Primers are commonly used before:
- Applying levelling compounds
- Applying adhesives (especially for glue-down LVT and bonded wood systems)
A good primer:
- Improves bond strength
- Reduces the risk of pin-holing and air release in levelling compounds
- Prevents rapid suction on porous substrates, which can weaken the finished layer
Primer type varies by subfloor (porous vs non-porous), so choose the correct one for the substrate you’ve identified.
Levelling Compounds
Levelling compounds are used to correct surface irregularities and create a smooth, uniform base for installation.
Drying time varies by product, temperature, and thickness, but a common rule of thumb is:
- Approximately 24 hours per 3mm depth
Do not rush this stage. Installing too early can trap moisture, weaken the bond, and compromise the floor’s long-term performance — especially with glue-down LVT, where imperfections and movement transfer straight through.
4. Environmental Conditions & Acclimatisation
Subfloor preparation does not end with moisture testing and levelling. Environmental conditions within the property must also be stabilised before installation begins.
Temperature and humidity directly affect both the subfloor and the flooring material. Installing in unstable conditions increases the risk of movement, expansion pressure, and bond failure.
Environmental Conditions During Preparation & Installation
Maintain:
- A minimum room temperature of 18°C
- Stable relative humidity levels
- No rapid heating or cooling cycles
- Windows and doors fully enclosed
Avoid introducing sudden heat immediately before or after installation. Sharp temperature changes can cause rapid expansion or contraction in both timber substrates and flooring products.
Underfloor Heating
Where underfloor heating is present:
- The system must be fully commissioned before installation
- Heating should be gradually brought up to operating temperature, then reduced prior to installation
- The system must not be used to “force dry” screeds
Moisture testing must still be carried out — underfloor heating does not guarantee dryness.
For detailed commissioning procedures, moisture cycling guidance, and flooring-specific considerations, please refer to our dedicated Underfloor Heating Guides.
Acclimatisation
Flooring materials must be allowed to adjust to site conditions before installation.
General guidance:
- Engineered wood: Minimum 48 hours
- Laminate: Minimum 48 hours
- LVT: Minimum 24 hours
- Solid Wood: Typically 5–7 days (subject to manufacturer guidance)
Always follow manufacturer-specific guidance where it differs.
Store unopened packs:
- Flat
- In the installation room
- Away from direct heat sources
- In stable environmental conditions
Acclimatisation does not replace moisture testing — it simply reduces the risk of rapid post-installation movement.
5. When to Seek Professional Assessment
Subfloor preparation can often be completed successfully with correct testing and careful execution. However, certain site conditions require specialist evaluation.
Professional assessment should be considered where:
- Structural cracking is present
- Moisture readings remain above acceptable limits
- Substrate integrity is uncertain
- Listed building or conservation restrictions apply
- Underfloor heating systems present commissioning or moisture concerns
- Large commercial or high-traffic areas are involved
In these situations, proceeding without specialist input increases the risk of installation failure.
A professional assessment may include:
- Comprehensive moisture mapping
- Core sampling of screed or slab
- Pull-off strength testing
- Thermal imaging (particularly where underfloor heating is installed)
Where doubt exists regarding structural condition or moisture behaviour, installation should not proceed until the substrate has been properly evaluated and certified as suitable.
6. Technical Quick Reference Table
| Subfloor Type | Maximum Moisture Content | Typical Levelling Depth | Maximum Deviation |
|---|---|---|---|
| Concrete | ≤ 75% RH or ≤ 2.0% CM | 3mm | ≤ 3mm over 2m |
| Timber | 8–12% moisture content | 2mm | ≤ 3mm over 2m |
| Anhydrite | ≤ 65% RH or ≤ 0.5% CM | 1mm | ≤ 3mm over 2m |
Rotate your device to landscape to view the full technical reference table.
| Subfloor Type | Maximum Moisture Level (General Guidance) | Surface Preparation Requirements | Flatness Tolerance | Additional Considerations |
|---|---|---|---|---|
| Concrete Slab / Sand & Cement Screed | ≤ 75% RH (hygrometer) or ≤ 2.0% CM | Prime before levelling or bonding | ≤ 3mm over 2m | Surface DPM required if no structural DPM or RH exceeds limit |
| Anhydrite / Liquid Screed | ≤ 65% RH or ≤ 0.5% CM | Laitance must be mechanically removed before priming | ≤ 3mm over 2m | Sanding mandatory before bonding; moisture testing critical |
| Timber Floorboards | 8–12% moisture content | Secure, stabilise, and overlay if required | ≤ 3mm over 2m | Subfloor must be within 2–4% of flooring moisture content |
| Plywood / Chipboard Deck | 8–12% moisture content | Secure fixings and check for movement | ≤ 3mm over 2m | Minimum 18mm thickness typically required |
| Beam & Block (with Screed) | ≤ 75% RH (test screed layer) | Confirm screed integrity and DPM presence | ≤ 3mm over 2m | Moisture testing applies to screed layer |
Values shown represent general UK guidance. Always follow specific flooring and adhesive manufacturer requirements where they differ.
7. Frequently Asked Questions on Subfloor Preparation
The following answers address common technical questions relating to subfloor preparation, moisture control and surface readiness prior to flooring installation.
No. A screed can feel dry on the surface while still retaining excess moisture within its depth. Installation should only proceed once moisture levels have been tested using an approved method (e.g. in-situ hygrometer) and confirmed within the manufacturer’s stated limits. Surface appearance or age of the screed alone does not confirm suitability.
Not necessarily. A levelling compound is only required if the subfloor exceeds acceptable flatness tolerances (typically 3mm over 2 metres) or if localised defects need correction. If the substrate is already within tolerance and structurally sound, additional levelling may not be necessary. Measurement should always be carried out before deciding.
No. Underfloor heating does not guarantee that a screed has reached acceptable moisture levels. While commissioning can help stabilise the substrate, moisture testing must still be carried out in accordance with recognised standards before installation. Heating should never be used to “force dry” a screed.
In most cases, no. Old adhesive residue can compromise bond strength and may react with new adhesives or levelling compounds. The surface must be mechanically prepared and free from contamination before priming or bonding. Refer to the Cleaning & Mechanical Preparation section for acceptable methods.
If deviation exceeds 3mm over 2 metres, corrective levelling is required before installation. Installing over an uneven substrate can lead to joint stress, lipping, adhesive failure, or premature wear. Flatness must be measured using a straight edge and corrected where necessary.
No. General construction plywood may contain internal voids or inconsistent bonding, which can lead to movement and failure. Flooring overlays should use appropriate flooring-grade plywood such as SP101 or BS EN 636-2 compliant boards, correctly fixed and free from core gaps.
Subfloor preparation underpins the performance of every flooring installation. Whether the finish is engineered wood, solid hardwood, laminate, SPC or glue-down LVT, long-term durability ultimately depends on the condition of the substrate beneath it.
Moisture must be verified, flatness accurately measured, and structural stability confirmed before installation begins. Surface preparation must then be completed correctly to ensure proper bonding and long-term performance.
Once flooring is installed, access to the substrate is limited and remedial work becomes considerably more disruptive and costly. Proper preparation at the outset protects the installation, safeguards warranties, and ensures the finished floor performs as intended for years to come.
Find Quick Answers
Dive into our FAQ section for instant answers to your most common questions, from product details to shipping information.
We're Here to Help
Need further assistance? Our dedicated team is ready to provide you with personalized support and answer any queries you might have.
About Floor Warehouse
Floor Warehouse is a UK-based flooring specialist with over 15 years of combined industry experience in sourcing, selling, and advising on wood, laminate, SPC, and LVT flooring. Our expert advice is written to help homeowners, designers, and trade professionals make informed flooring decisions — from installation and maintenance to underfloor heating compatibility, sustainability, and long-term performance. All guidance is based on real-world product knowledge, manufacturer standards, and common questions we see every day from customers across the UK.
View all posts by Floor Warehouse
